Aerial view of the Jocko River beside an open irrigation canal

Projects · Current

Jocko Pipelines

Converting aging open canals to buried pipelines to improve water delivery efficiency, reduce water loss, and modernize irrigation infrastructure.

Project Overview

From open canal to pressurized, buried pipe

The Jocko Service Area of the Flathead Indian Irrigation Project has been identified as a high-priority target for rehabilitation, betterment and modernization as it relates to water delivery efficiencies. The Jocko K Canal irrigation service area will be rehabilitated with a delivery network of pressurized, buried pipe. Pressurized pipe operates by completely filling the pipe with water, allowing the pipe to pressurize by the effect of gravity.

A Master Plan for the area was developed as a collaborative effort between the engineering services of Morrison-Maierle, CSKT, and FIIP staff. The conceptual design is split into six phases over the next few years that will involve 17.7 miles of pipeline. Some of the challenges in the Jocko service area include canals overgrown with vegetation, high seepage, due to the character of underlying soils, and flow control structures.

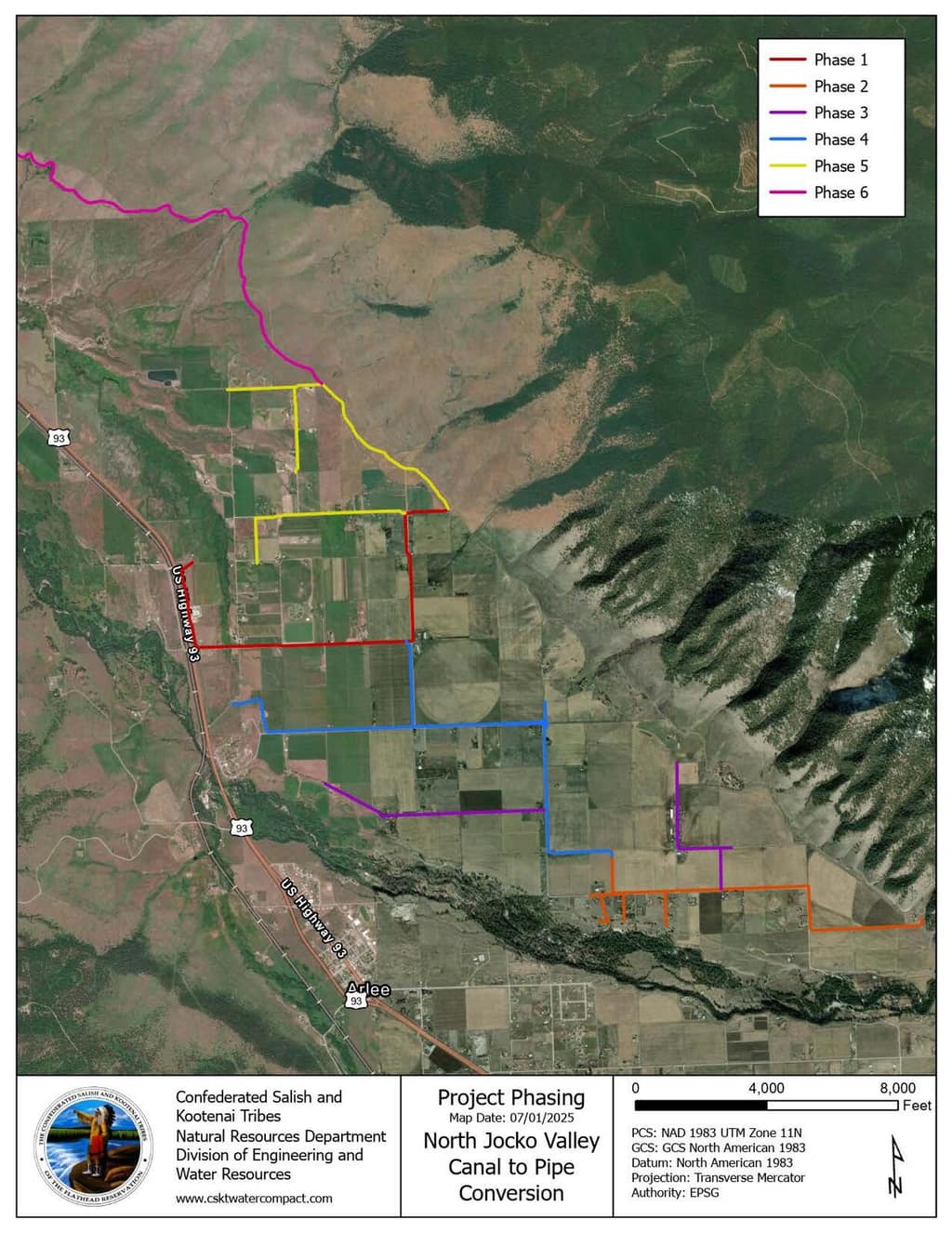

Jocko pipelines project phasing map showing the six construction phases

17.7

miles of pipeline

6

construction phases

2025-2027

construction

Workflow Timeline

Where each phase stands

Design: 2022-2023 · Construction: 2025-2027

Design: 2022-2023

  • Design Consultant: Morrison-Maierle, Inc.
  • Master Plan developed with CSKT and FIIP staff

Phases 1 & 2

  • Contractor: Prospect Construction
  • Project is under construction. Substantial completion due April 2026.

Phases 3 & 4

  • Contractor: Knife River Corp
  • Project is under construction. Substantial completion due April 2026.

Phases 5 & 6

  • Bidding anticipated February 2026.
  • Status: AWARDED — Contract Awarded: Knife River. Anticipated to begin following the 2026 irrigation season.

Where

Roads affected by construction

Construction will occur east of Highway 93 between Oliver Thomas Lane and Sodfarm Road. Please expect construction vehicles and occasional traffic interruption on the following roads:

  • Oliver Thomas Lane
  • Theresa Adams Lane
  • McLeod Road
  • Dumontier Road
  • White Coyote Road
  • Martz Drive
  • Scotch Pine Lane
  • Lost Horse Lane

What to Expect

During construction

Traffic detours

Traffic detours will help maintain access during construction.

Local access

Local access will remain open.

Marked and secured

Construction zones will be clearly marked and secured for safety.

Irrigation continues

Irrigation services will not be disrupted.

Project Team

Who is building it

CSKT

BIA – FIIP

Design Consultant: Morrison-Maierle, Inc.

Contractors: Prospect Construction (Phase 1 & 2), Knife River Corp (Phase 3 & 4)

Explore the project on the map

Click Here to View an Interactive StoryMap about the Jocko Pipelines Project.
